Business tips
How to Build a Bakery Production Schedule
Build a bakery production schedule using confirmed orders, smart batch planning, prep lists, bake-day timing, and pickup workflows designed
At a glance
- Build schedules around confirmed demand, kitchen constraints, production tasks, and customer handoff deadlines.
- Work backward from the customer deadline so packing, cooling, finishing, baking, and prep all have realistic time.
- Keep confirmed orders separate from forecasts, and protect reserved work before using spare capacity for speculative stock.
Your bread is ready to shape, the cake still needs its final coat, and the cooling rack is full of pastries meant for the market. Then a customer messages to ask whether they can collect early. You've got the orders written down, but you still don't know which job can safely wait.
A workable bakery production schedule connects those orders to the kitchen and the person doing the work. It accounts for the refrigerator shelf you have, the time you need away from the kitchen, and the moment each customer expects a finished, packed order.

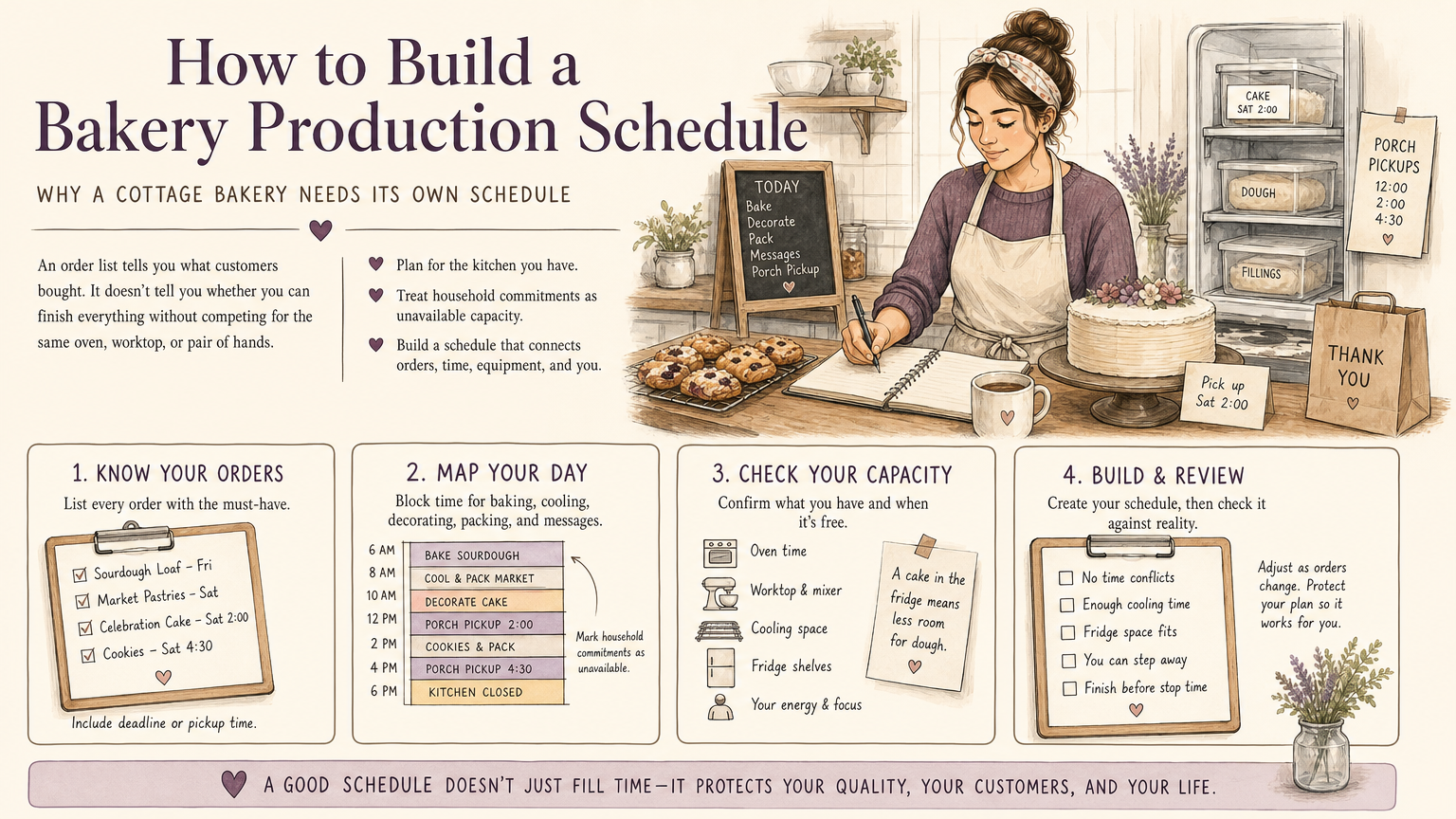

Why a Cottage Bakery Needs Its Own Schedule
Consider a home bakery morning with sourdough waiting to bake, market pastries cooling, and porch pickups due later. A celebration cake occupies the refrigerator space you'd normally use for dough. The household still needs the kitchen, and you're responsible for production, packing, messages, and handoff.
An order list tells you what customers bought. It doesn't tell you whether you can finish everything without competing for the same oven, worktop, or pair of hands.
Plan for the kitchen you have
Copying a high-volume production plan can make a home bakery look more capable on paper than it is in practice. You might have enough oven time across the week but no uninterrupted decorating time before a cake collection. Another tray of pastries might fit in the oven but have nowhere to cool.
Treat household commitments as unavailable capacity, not interruptions you'll somehow absorb. Mark school runs, shared kitchen use, appointments, and your stopping time before assigning business tasks.
- Equipment availability: Record when the oven, mixer, refrigerator, and worktop are available for bakery use.
- Hands-on availability: Separate tasks you must actively perform from fermentation, chilling, and other waiting periods.
- Selling commitments: Distinguish customer promises from stock you hope to sell.
Define a usable schedule
Your schedule should connect confirmed demand, batch quantities, preparation tasks, bake blocks, and customer handoffs. Each job needs a place in the sequence, not merely a date beside its name.
Bakery production-planning guidance frames planning around constraints such as batch sizes, oven capacity, proofing, staffing, and deadlines. For a cottage operation, apply that thinking to household resources rather than assuming dedicated commercial facilities.
The practical test is simple: can you follow the plan without inventing extra refrigerator space or pretending you can decorate while answering the door? If not, reduce the commitment before production begins.
Map Your Demand and Bake Days
Start with selling commitments, not empty calendar squares. Gather orders from your shop, messages, custom-order records, market reservations, and standing customer arrangements. Reconcile them before deciding what belongs on each bake day.
Keep demand channel separate from collection method. A preorder collected from the porch is still the same order, not additional porch-pickup demand. That distinction prevents you from counting a customer's purchase again when you build the handoff list.

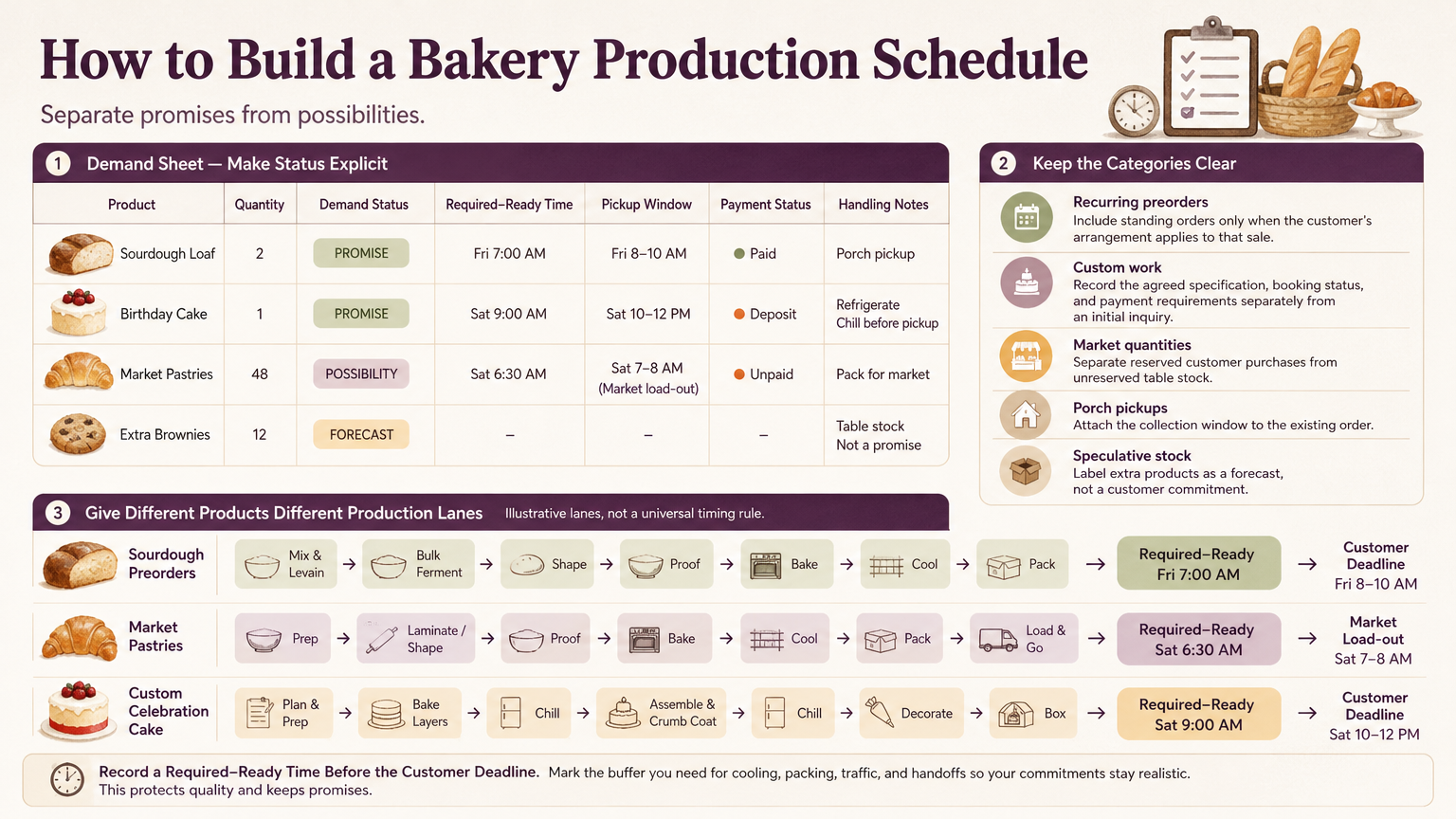

Separate promises from possibilities
Use a demand sheet with product, quantity, demand status, required-ready time, pickup window, payment status, and handling notes. Make the status explicit rather than relying on memory.
- Recurring preorders: Include standing orders only when the customer's arrangement applies to that sale.
- Custom work: Record the agreed specification, booking status, and payment requirements separately from an initial inquiry.
- Market quantities: Separate reserved customer purchases from unreserved table stock.
- Porch pickups: Attach the collection window to the existing order.
- Speculative stock: Label extra products as a forecast, not a customer commitment.
Give different products different production lanes
For example, suppose your week includes sourdough preorders, pastries for a weekend market, and a custom celebration cake. Don't assign everything to a general baking day.
Give the sourdough a fermentation and baking lane linked to its collection commitment. Put market pastries in a lane linked to departure time, including packing and loading. Give the cake its own staged preparation, chilling, finishing, and collection blocks. These are illustrative planning lanes, not a claim that every recipe should follow the same timing.
Record a required-ready time before the customer-facing deadline. Market stock must be packed before you leave home; a cake must be finished before you need to clear the decorating station for handoff.
Cutoff rule: Close ordering when another order would require changing an already committed production block, not when you finally run out of ingredients.
Set cutoffs by product. A late request for an existing, compatible batch deserves a different capacity check from a new cake design or an additional fermented product.
When a request remains conditional, give it an expiry point. Otherwise, you can end up reserving labor for an unconfirmed project while refusing work that could be booked.
Plan Batches Around Capacity
A batch should begin with an identified destination for its output. Add confirmed quantities by product, then keep any market forecast or safety allowance visibly separate. Don't round up because the mixer could hold more.
If you allow for damage or production variation, base that allowance on your own records and document its purpose. Extra stock for hoped-for sales is a different decision from a replacement allowance for committed orders.
Batch planning by product group
| Product group | Demand basis | Capacity to check | Scheduling decision |
|---|---|---|---|
| Long-ferment bread | Confirmed preorders, with any allowance identified separately | Mixer, proofing containers, refrigerator, oven, racks | Group compatible dough work, but protect fermentation and baking space |
| Same-day pastries | Reserved orders plus a deliberate market forecast | Worktop, trays, chilling space, oven, packing station | Share a bake block only when handling and bake profiles fit |
| Decorated cakes | Confirmed custom bookings | Decorating time, chilling space, finishing equipment | Reserve skilled labor and storage before accepting another booking |
| Market assortments | Reservations plus unreserved selling stock | Combined preparation, display packing, transport readiness | Limit variety when extra products add disproportionate setup work |
Compatible grouping is worth considering. In industrial bakery research, a product-wheel scheduling method was estimated to reduce changeover time by 42 hours, or 18%, but that result isn't a home-bakery performance promise (product-wheel scheduling research).
The useful principle is to reduce unnecessary switches between recipes, settings, equipment, and ingredient setups. Review your bakery menu ideas through that lens: a varied menu isn't automatically a workable production menu.
Find the resource that runs out first
Check the whole route through the kitchen. A mixer-sized batch may exceed proofing space. The oven may accommodate everything while the cooling racks cannot. Packaging can become the limiting step even after baking goes smoothly.
For each batch, ask:
- Can it fit physically? Check containers, shelves, trays, racks, and finished-order storage.
- Can you attend to it? Look for shaping, decorating, and packing tasks that need you simultaneously.
- Can you sell or reserve it? Identify the intended customer or selling channel.
- Is the extra work worthwhile? Compare the additional contribution with the scarce labor or equipment time it consumes.
A full oven is an equipment measure, not a profit measure. My planning preference would be to protect reserved customer work before using spare capacity for speculative variety.

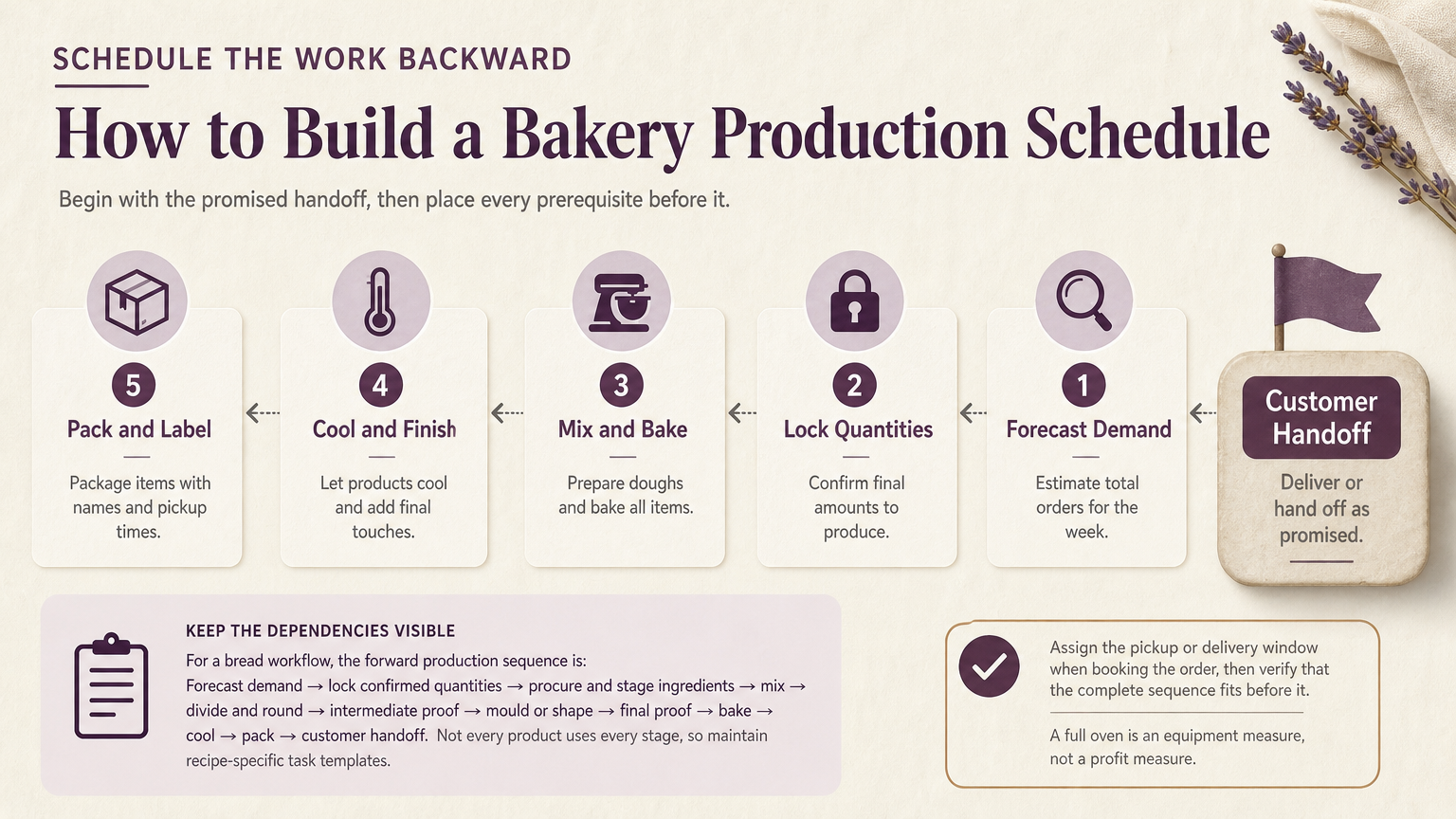

Schedule the Work Backward
Begin with the promised handoff, then place every prerequisite before it. If you start with the time you'd like to mix, you may discover too late that cooling, finishing, or packing won't fit.
Write the customer deadline first. Before that, reserve packing and checking time; before packing, reserve cooling and finishing; before cooling, place baking. Continue backward through proofing, shaping, dough preparation, and ingredient staging.
Keep the dependencies visible
For a bread workflow, the forward production sequence is:
Forecast demand → lock confirmed quantities → procure and stage ingredients → mix → divide and round → intermediate proof → mould or shape → final proof → bake → cool → pack → customer handoff.
Assign the pickup or delivery window when booking the order, then verify that the complete sequence fits before it. Not every product uses every stage, so maintain recipe-specific task templates rather than forcing cakes, pastries, and bread into an identical checklist.
Proofing ranges illustrate why generic timing fails: approximately 45–60 minutes for wheat rolls and morning goods, 60–90 minutes for white tin bread, 30–90 minutes for baguettes, 1–3 hours for ambient-proofed sourdough, and 8–24 hours for shaped sourdough under cold proofing, depending on product and process (bread-proofing guidance).
Use those ranges as context, not instructions to override your recipe or dough condition. Record the timing you observe under your own production conditions.
Separate waiting time from available time
A dough resting in the refrigerator may free your hands, but it doesn't free refrigerator space. A cake chilling between stages may leave time for another task, but only if you can return to it when required.
For made-to-order desserts, show each finishing stage separately. A calendar entry labelled cake hides too much: preparation, baking, cooling, filling, chilling, decorating, and packing need their own positions.
- Reserve transitions: Include cleaning, sanitation, ingredient changes, and oven adjustments.
- Check simultaneous demands: Don't assign yourself to shaping dough and detailed decorating at the same moment.
- Protect cooling space: Reserve rack or counter capacity until the product can move onward.
- Place contingency deliberately: Keep a small unallocated block near work with uncertain timing rather than assuming everything will finish early.
Buffer time belongs to the schedule. It isn't spare capacity to sell before the bake has started.
When backward planning pushes the start beyond your available working time, change the offer. Adjust the collection arrangement, simplify the work, or decline the order rather than compressing necessary stages.

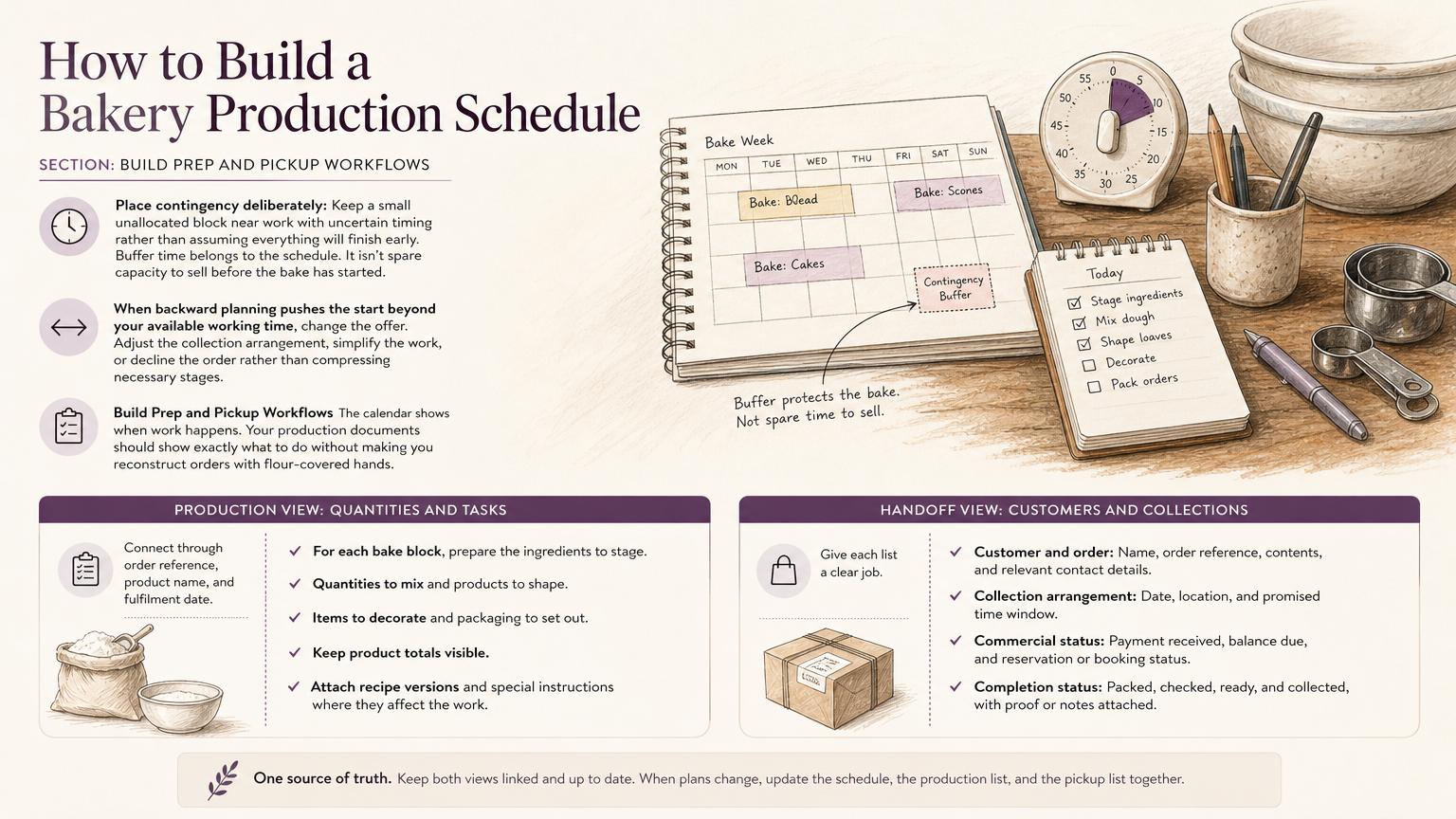

Build Prep and Pickup Workflows
The calendar shows when work happens. Your production documents should show exactly what to do without making you reconstruct orders with flour-covered hands.
Use a production view for quantities and tasks, and a handoff view for customers and collections. Connect them through an order reference, product name, and fulfilment date.
Give each list a clear job
For each bake block, prepare the ingredients to stage, quantities to mix, products to shape, items to decorate, and packaging to set out. Keep product totals visible, with recipe versions and special instructions attached where they affect the work.
Your pickup list needs different information:
- Customer and order: Name, order reference, contents, and relevant contact details.
- Collection arrangement: Date, location, and promised time window.
- Commercial status: Payment received, balance due, and reservation or booking status.
- Completion status: Packed, checked, ready, and collected, with an exception note where necessary.
Don't use a tick beside the customer's name to mean both paid and collected. Give each status its own field.
Keep distinct work visible
Consider a bake containing bread preorders, reserved market pastries, unreserved market stock, and a celebration cake. The confirmed bread quantities become a bread prep total. Reserved pastries contribute to their product totals but retain named collection records.
Unreserved market pastries belong on the market stock sheet, not a fictional customer pickup entry. The cake remains a separate custom job with its specification and finishing tasks, even if it shares some ingredient preparation with other work.
A spreadsheet and printed checklists can support this setup. If you're considering bakery order management software, check whether its production and handoff views preserve those distinctions instead of requiring you to maintain competing totals.
Keep a clearly identified current version of each working list. When an accepted change affects quantity, update the production record and the customer-facing record together.
For a solo baker, use the handoff view to arrange collection periods around active production. For a team, assign responsibility for packing checks and collection updates so a finished bag doesn't leave without its status being recorded.
Avoid Common Scheduling Traps
A busy bakery production schedule can still be a poor commercial decision. The clearest warning is work that fills the day but leaves unsold products, unpaid administration, or rushed customer commitments.
A Swedish bread-supply-chain study identified overproduction and poor production planning among frequent causes of bakery waste, with bakery-stage losses representing 14.9% of total bread waste across the examined chain. That isn't a cottage-bakery waste benchmark, but it supports questioning production volume rather than treating more output as the default goal.
Diagnose the failure before adding hours
| Scheduling trap | What to change |
|---|---|
| Baking extra because ingredients are available | Reduce speculative stock and give each planned batch a selling purpose |
| Grouping products because they share a bake day | Check actual temperature, handling, and labor compatibility |
| Treating cooling as unoccupied time | Reserve the physical space and the later packing task |
| Booking custom work as a single calendar entry | Expose chilling, finishing, and decorating stages |
| Accepting late orders because the oven has room | Check every affected resource and customer deadline |
| Holding a custom slot indefinitely without payment certainty | Apply your stated booking, deposit, and release policy |
An inquiry isn't a confirmed order. A forecast isn't a reservation. Keep those distinctions visible when deciding whether an additional purchase, batch, or decorating block is justified.
Know when less work is the better choice
Suppose a late cake request fits the oven schedule but consumes the decorating block reserved for existing work. Accepting it would require evening labor, another cleanup, and a changed household commitment. The additional sale deserves a fresh commercial decision, not an automatic yes.
Compare the expected contribution after ingredients, packaging, and other order-specific costs with the constrained time it requires. Include the work you're tempted not to count: quoting, shopping, customer changes, packing, and cleanup.
A useful boundary: Don't promise a customer capacity that exists only if nothing goes wrong and your own time has no value.
A smaller, fully paid schedule can be more profitable than a broader menu with unsold stock and unpaid rush work. That's a decision to test against your records, not a universal promise.
After a difficult bake, identify the original planning mistake. If packing ran late because cakes occupied the finishing station, adding an earlier mixing start won't fix the conflict. Correct the resource allocation or sales commitment that caused it.
Review and Improve the Schedule
After collection ends, compare the plan with what happened. Keep the review small enough that you'll complete it while the details are still fresh.
Record planned units, baked units, sellable units, leftovers, returns, waste, labor hours, and pickup performance by product. Note the cause of meaningful exceptions, such as a damaged item, a late ingredient delivery, or a finishing task that took longer than expected.
Make the next decision easier
Use a short review sheet rather than a narrative account of the entire day.
- Quantity changes: Compare recent preorder history with actual purchases and leftovers by product and selling occasion.
- Timing changes: Identify the task or resource that caused a missed production target.
- Menu changes: Flag products whose preparation or finishing disrupted more valuable committed work.
- Customer changes: Record collection problems or unclear instructions that need a different booking process.
Compare similar selling days rather than treating every market or pickup session as interchangeable. Adjust the next schedule using those observations, and avoid rewriting a reliable process because of an isolated exception.
Keep the records connected
A solo operator can maintain the review beside the working production sheet. In a larger team, let production record output and waste while the person handling collections records handoff exceptions; whoever plans the next bake reconciles both.
A spreadsheet with printed lists is one option. Ovenbell is another: its auto-generated prep lists total confirmed quantities by item, while pickup lists show timeslots, collection status, and who is due to arrive. Its workspace also supports custom requests, deposits, balances, and customer details.
Whichever system you use, correct the underlying order record rather than leaving changes in messages or on loose paper. The next production list should reflect the decision you made.
Start with the coming week: gather your confirmed orders, choose a clear pickup deadline, and build backward until every necessary task has a realistic place. Then remove or defer anything that doesn't fit your kitchen, your equipment, and your available working time.
A little more clarity
Your questions, answered
What should a cottage bakery schedule account for?
It should account for available equipment, work space, your hands-on time, household commitments, and customer handoff deadlines.
How should I decide when to stop taking orders?
Close ordering when a new order would require changing a production block that is already committed. Set different cutoffs by product.
Why plan production backward from pickup or delivery?
Starting with the promised handoff helps ensure that packing, cooling, finishing, baking, and earlier preparation all fit before the deadline.
Does waiting time free up capacity?
It may free your hands, but it does not necessarily free refrigerator, chilling, cooling, or other physical space.
What information belongs on a pickup list?
Include the customer and order details, collection date and time window, payment or booking status, and whether the order is packed, checked, ready, and collected.
What should I review after a bake day?
Compare the plan with actual units, leftovers, waste, labor hours, pickup performance, and meaningful exceptions by product.
